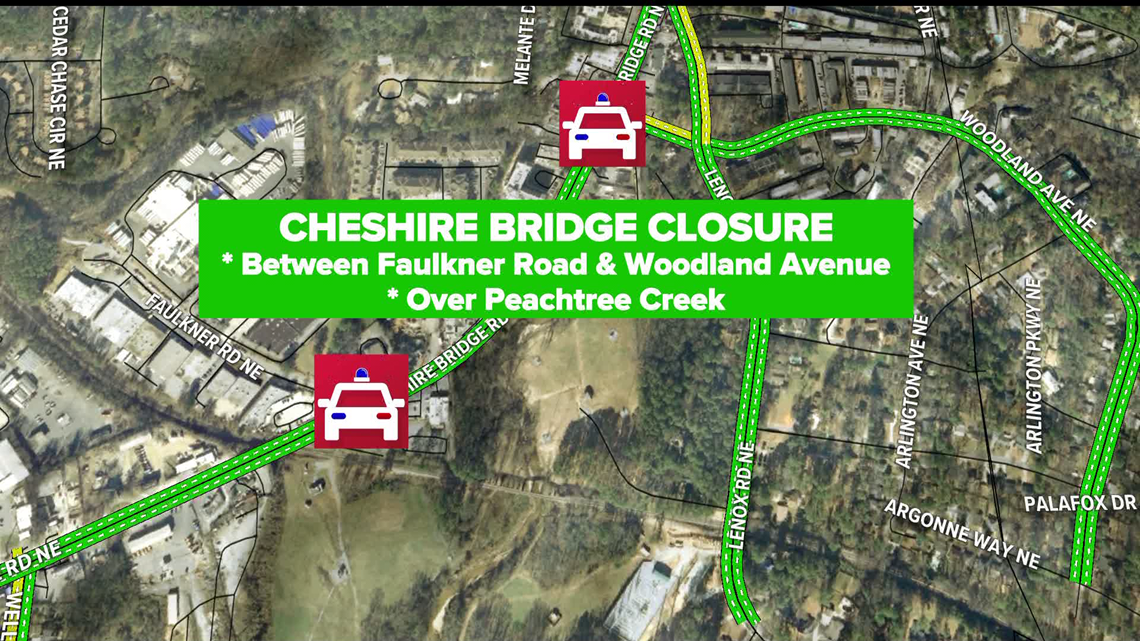

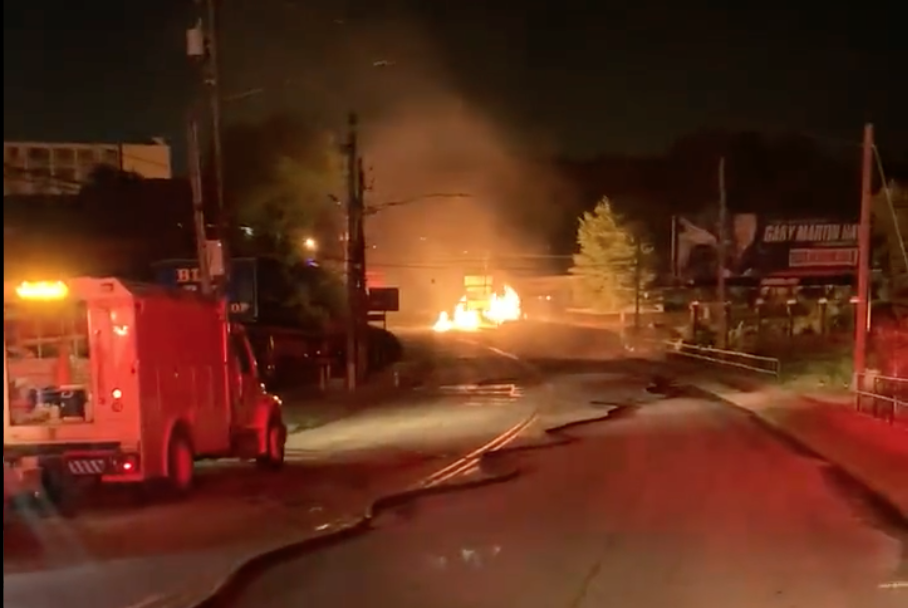

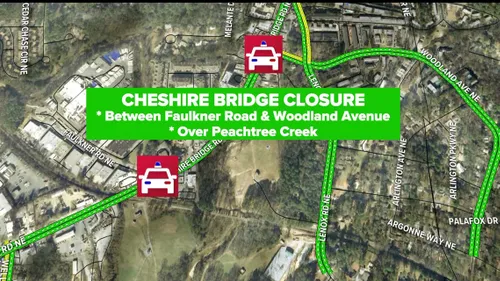

Effective immediately, Cheshire Bridge Road from Woodland Avenue NE to Faulkner Road NE is closed to all traffic until further notice. The bridge is closed for the safety of the traveling public due to damage caused by a fire effective Wednesday, August 4, 2021.
Please see below for regular updates.
.jpg)
Cheshire Bridge Rebuild Update
The City of Atlanta Department of Transportation (ATLDOT) has contracted with C. W. Matthews for the design and rebuild of the Cheshire Bridge over South Fork Peachtree Creek. This comes after accepting, reviewing, and evaluating all bids submitted in January 2022.
Cheshire Bridge Rebuild Update
After accepting, reviewing, and evaluating all bids submitted, the City of Atlanta Department of Transportation (ATLDOT) has forwarded a contractor recommendation for the design and rebuild of the Cheshire Bridge over South Fork Peachtree Creek. Bids from prospective contractors were due on February 1, 2022.

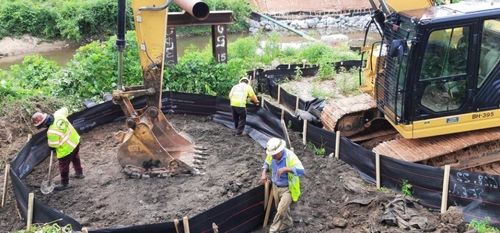

Cheshire Bridge Rebuild Update
With demolition complete, the City of Atlanta Department of Transportation (ATLDOT) is currently accepting bids for the design and rebuild of the Cheshire Bridge over South Fork Peachtree Creek. Bids from prospective contractors are due on Tuesday, February 1, 2022.

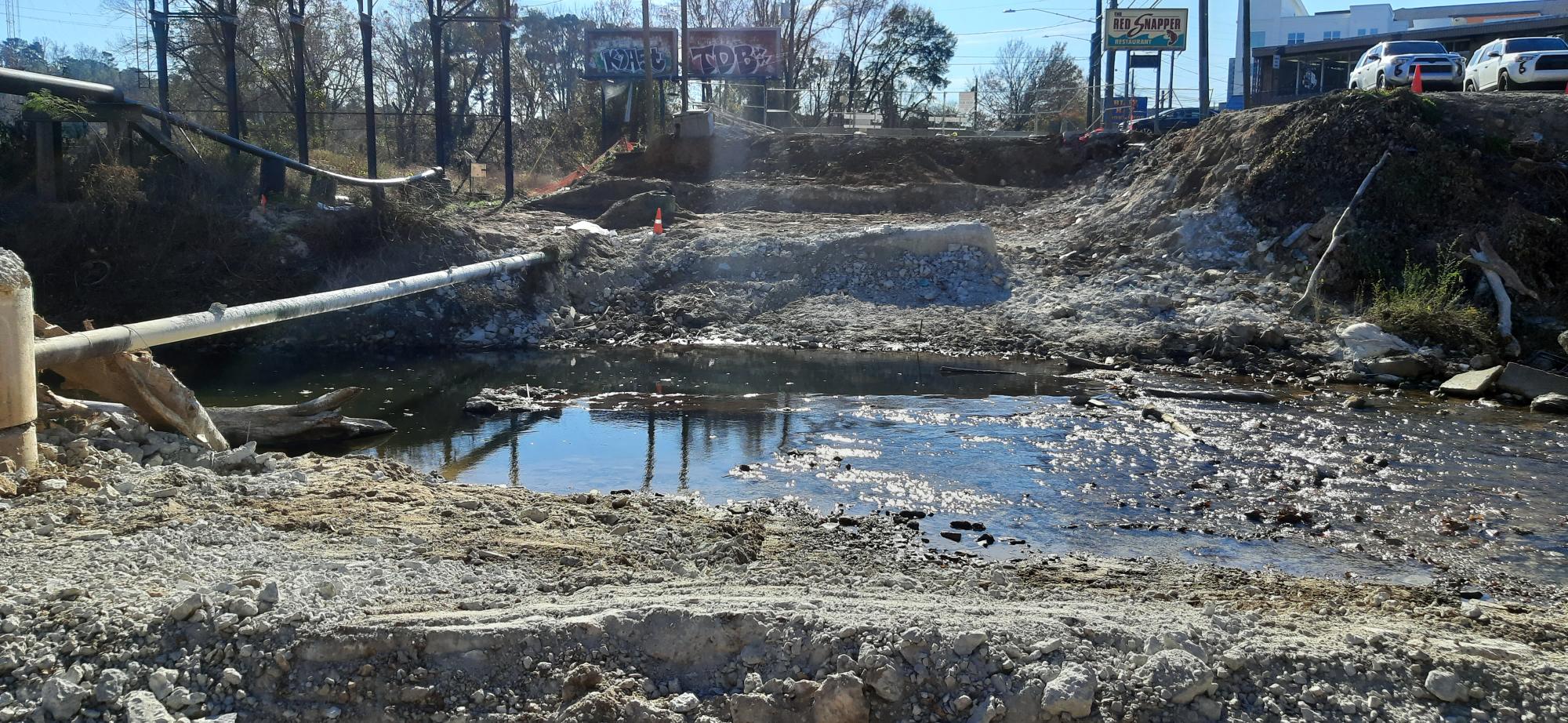

Cheshire Bridge Demolition
The City of Atlanta Department of Transportation (ATLDOT) is pleased to announce demolition of the Cheshire Bridge over South Fork Peachtree Creek has been completed as scheduled.

Cheshire Bridge Demolition
The City of Atlanta Department of Transportation (ATLDOT) announced utility relocation work is complete on the fire-damaged Cheshire Bridge over South Fork Peachtree Creek, clearing the way for demolition work to begin the week of November 8th

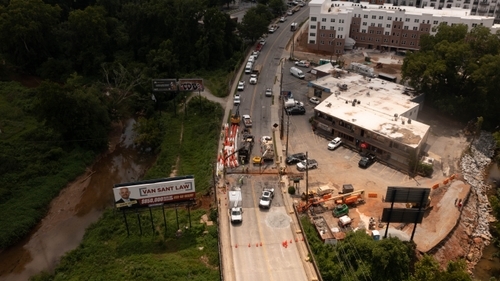

Cheshire Bridge Rebuild Update
Below is a summary of rebuild activities for September 21-October 5, 2021, that have been completed, are in progress, and planned for implementation.

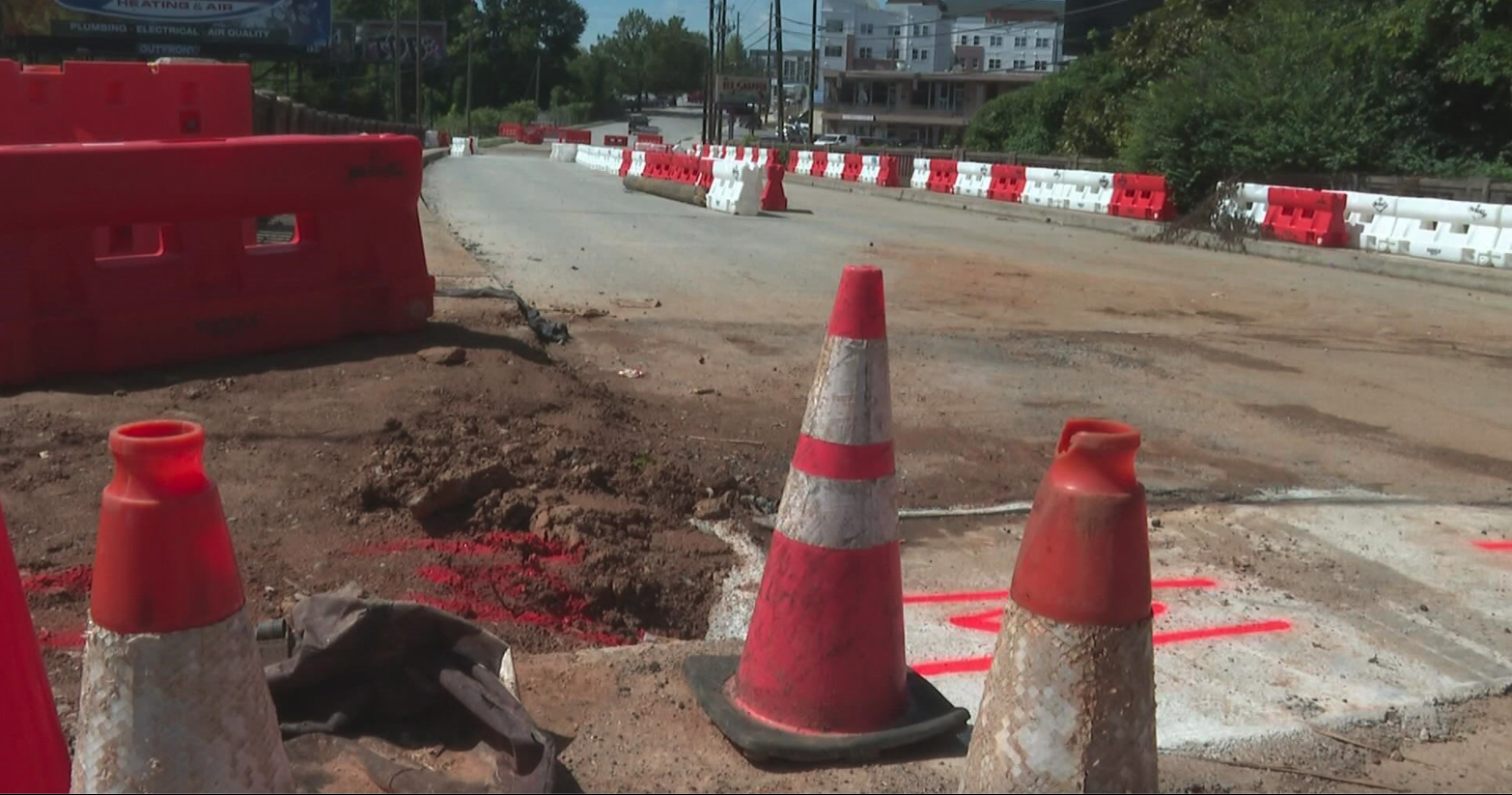

Cheshire Bridge Rebuild Update
Below is a summary of rebuild activities for September 7-September 20, 2021, that have been completed, are in progress, and planned for implementation.

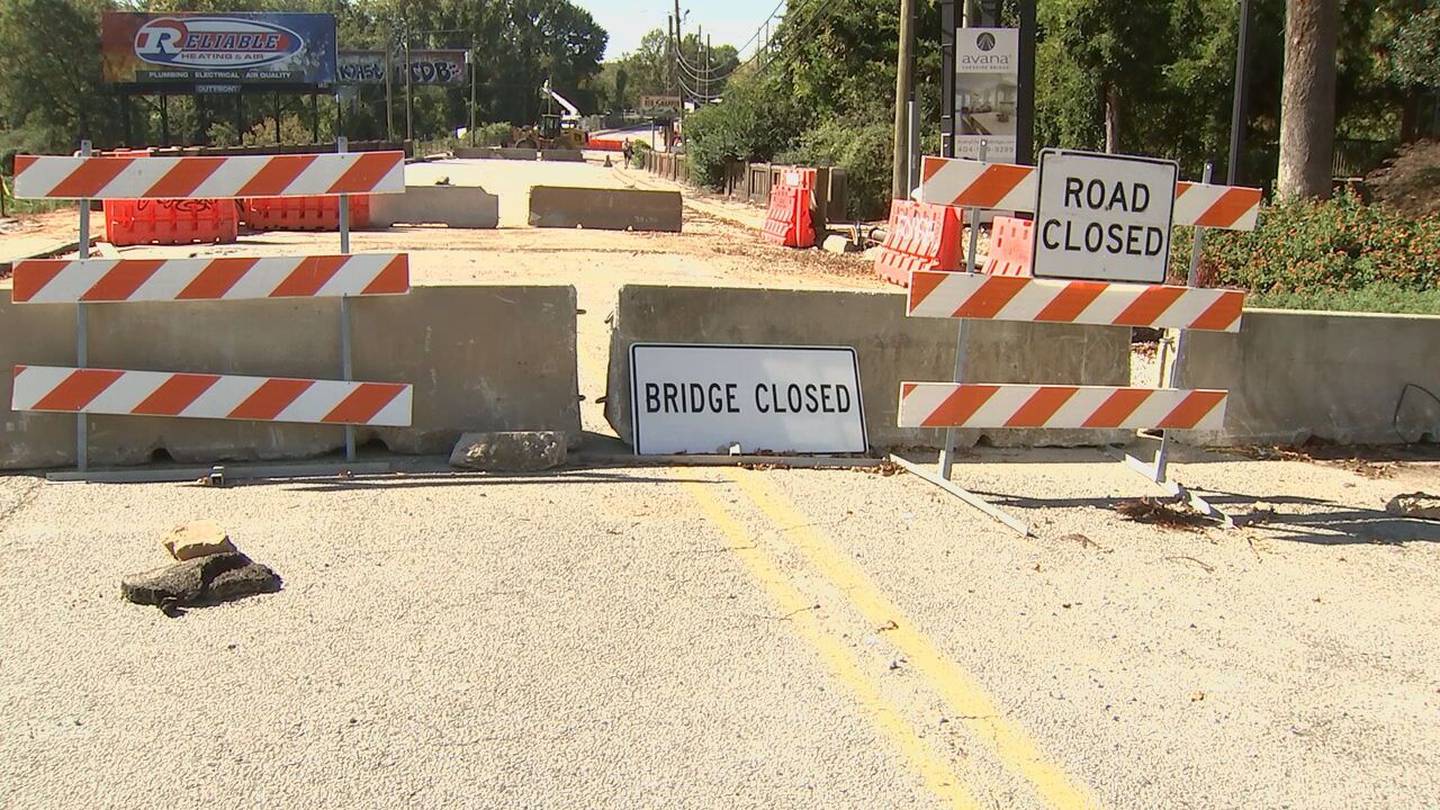

Cheshire Bridge Response and Recovery Phases Complete
The Atlanta Department of Transportation has completed the response and recovery efforts associated with the fire on August 4, 2021, which severely compromised the efficacy of Cheshire Bridge over South Fork Peachtree Creek. Below is a summary of rebuild activities for August 23-27, 2021 that have been completed, are in progress, and planned for implementation.

Transportation Committee Update
On Wednesday, August 11, Atlanta Department of Transportation (ATLDOT) Commissioner Josh Rowan provided an update on ATLDOT’s Response and Recovery efforts related to the fire near the northeast corner of Cheshire Bridge over South Fork Peachtree Creek on August 4-5, 2021. Watch video to hear Commissioner Rowan’s update. The update begins at the 26:15 mark of the Transportation Committee video recording.
